The Swimming Pool Construction Process in Tulsa: Step-by-Step

Jason Cherry

Jason Cherry

Silverado Rock Pools

Quick Answer

Quick Answer: Building a pool in Tulsa takes 3 to 6 months for a gunite pool, 2 to 4 weeks for a vinyl-liner pool, and 2 to 5 weeks for a fiberglass pool. The process has 10 stages: site evaluation, 3D design, permits, excavation, shell installation, plumbing and electrical, pressure testing, equipment setup, concrete decking, and pool school. Tulsa clay soil, city permit timelines, and Oklahoma weather all affect how the process goes.

Most Tulsa homeowners know what they want their pool to look like. What they don't know is what happens between signing the contract and jumping in the water.

That unknown is where most of the worry comes from.

Custom inground pool construction completed by Silverado Rock in Tulsa, OK

The bad stories you've heard from neighbors are rarely about the pool itself. They're about the builder who went quiet for two weeks. The surprise charge nobody mentioned. The crew that vanished mid-project. The homeowner had no idea what was happening or why.

This article fixes that. By the time you finish reading, the process won't feel like a mystery. It'll feel manageable. If you're still deciding which pool type is right for your yard, start with our inground pool builder page or our semi-inground pool page first.

Pool Construction Process Timeline: How Long Does Each Pool Type Take?

Here's the number most Tulsa homeowners want to know first.

Pool TypeBuild TimelineMain Variable
Fiberglass3 to 5 weeksShell delivery
Vinyl liner4 to 6 weeksPermit timeline
Gunite3 to 6 monthsConcrete cure time

That clock doesn't start until the permit is approved. Add 1 to 3 weeks for permits, depending on which city you're in. Tulsa moves fast. Bixby takes the longest.

Want to swim by June? Start your site evaluation in January or February. Every week you wait is a week you won't be in the water.

Most Tulsa homeowners don't have to pay for the pool upfront. Financing options are available for qualified buyers.

Why Building a Pool in Tulsa Is Different

Tulsa is not like Phoenix, Dallas, or Florida. Three things make it different.

Oklahoma clay soil. Tulsa sits on some of the most expansive clay soil in the country, according to USDA soil survey data. Clay swells when it gets wet. It shrinks when it dries out. That movement affects how the pool is dug, how the ground is backfilled, and how your deck holds up over 10 to 20 years. A builder who ignores this is not paying attention.

Different permit rules in every city. There is no single Tulsa permit process. Every city runs its own. Broken Arrow takes about two weeks. Bixby takes two to three weeks and asks for more paperwork. Jenks and Owasso have their own requirements. The permit step is the most unpredictable part of the whole timeline.

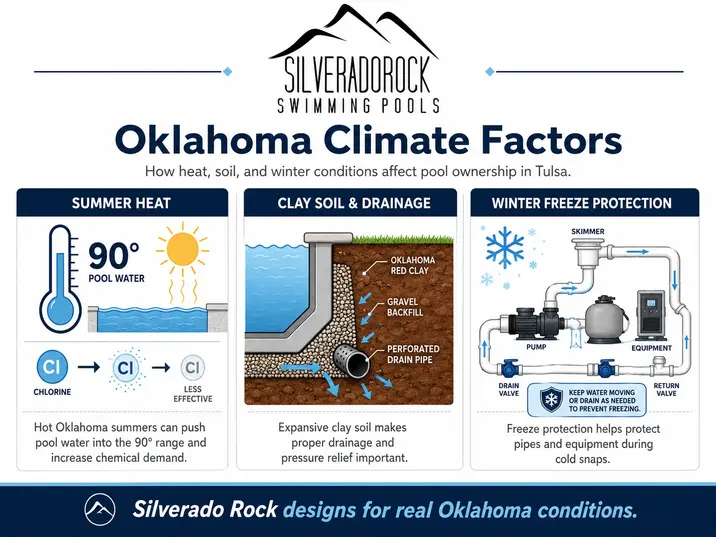

Weather factors that affect building pools in Oklahoma.

Oklahoma weather. Tulsa averages 49 inches of rain per year, most of it in spring. Digging a pool in a rain-soaked clay yard is a real problem. So is pouring concrete in a cold snap. Weather is part of every Tulsa build schedule.

A builder who treats Tulsa like every other market will surprise you. Surprises on a $50,000-$100,000 project are expensive.

The 10 Stages of Pool Construction in Tulsa

Stage 1: Site Evaluation

The process doesn't start with design. It starts with your yard.

A real site evaluation considers slope, drainage, yard access, utility lines, setbacks, easements, and soil conditions. It's also when HOA rules get checked before they become a problem later.

What a good site evaluation prevents: design changes after permits are filed, surprise charges during digging, and finding out mid-build that the equipment can't get into the yard.

Most builders treat this as a 10-minute walkthrough. The good ones spend 45 minutes and write everything down.

Ask this: "What exactly do you look at during the site visit — and how does it change the design or the price?" A builder who can't answer that specifically is guessing.

Stage 2: 3D Design

After the site visit, your pool is designed in 3D software. You see exactly what it will look like in your actual backyard before anything gets built.

This matters more than people expect. The design stage is where you catch a feature that won't fit the yard. It's where the outdoor kitchen gets placed correctly. It's where drainage is built into the deck rather than added later.

Changing something in a 3D design costs nothing. Changing it after the hole is dug can cost $2,000 to $8,000.

Few pool builders in Tulsa use professional 3D design software. If you can't send a realistic image to your family and HOA before work starts, you're going in blind.

Stage 3: Permits

Every inground pool in Tulsa requires a permit. Oklahoma Administrative Code Section 310:315-7-2 sets the state-level rules. Every city adds its own on top.

Here's how long it takes by city:

CityTypical WaitWhat They Need
Tulsa1 to 2 weeksSite plan showing pool location and distances
Broken Arrow2 weeksPlot plan, setback measurements, equipment location
Bixby2 to 3 weeksHome footprint, pool-to-house and pool-to-street measurements
Jenks1 to 2 weeksSite plan, drainage plan, fencing documentation
Owasso2 weeksPlot plan, setback documentation

The permit requires a plot plan showing where the pool is located, how far it is from the property line, and other measurements. If the homeowner doesn't have their property plat, it has to be pulled from the county records office first.

The biggest permit mistake homeowners make: trying to file it themselves.

Permit offices don't call you if something's missing. They move your application to the back of the pile. You find out two weeks later that you're starting over. Builders who do this every week know exactly what each city wants. Homeowners who do it once almost always leave something out.

Once the permit is filed, the timeline is out of the builder's hands. Any builder who promises a start date before the permit is approved is not being straight with you.

How to Prepare Your Yard Before Excavation Starts

Before the equipment shows up, here are eight things to take care of.

  1. Call 811. Oklahoma law requires utility lines to be marked before any digging. Call 811 or visit okie811.com at least three business days before your excavation date.
  2. Take down fence sections. Equipment needs at least 10 to 12 feet of clear access. Figure out which panels come down before day one.
  3. Clear the yard. Move furniture, planters, and anything within 15 feet of where the pool will go.
  4. Find your septic system if you're not on city sewer. Septic tanks have setback rules that affect where the pool can go.
  5. Cut back trees near the digging zone. Roots in the way add time and cost.
  6. Tell your neighbors. Excavation equipment is loud. Heavy trucks will be close to your property line.
  7. Contain your pets. Open fence sections and heavy machinery don't mix well.
  8. Get HOA approval first. This should be in hand before excavation starts, not during.

A good builder walks through this list with you during the permit phase. One who shows up without checking is less experienced than they've let on.

Stage 4: Excavation

Permit approved. Now the yard changes.

Heavy equipment comes in and digs out the shape of the pool. In Tulsa, clay soil holds water differently than sand. If it rains hard during excavation, the hole can fill, and work has to stop until it drains. That's not a builder failure. That's Oklahoma.

Access is everything at this stage. If the yard is tight, smaller equipment has to be used, and the job takes longer. That's why the site evaluation matters.

Excavation also reveals what the ground looks like beneath the surface. Buried rock, old debris, or unexpected soil conditions can come up. A builder who did a real site evaluation will have planned for most of it. One who skipped it will call you with a change order.

Stage 5: Pool Shell Installation

What happens next depends on the pool type you chose.

Fiberglass Pool Construction Process

A crane brings in the pre-made shell and sets it into the hole. It gets leveled and checked in all directions. The crane is usually on-site for half a day. Because the shell arrives ready to go, this is the fastest stage of any pool type. See what's included in our fiberglass pool installation.

Vinyl Liner Pool Construction Process

Steel or polymer wall panels go around the edge of the hole. The floor gets shaped into its final form. Custom features like tanning ledges and built-in steps are formed at this stage. This typically takes one to two days. See everything included in our vinyl liner pool installation.

Gunite Pool Construction Process

Steel rebar is laid out and tied together into the shape of the pool. After inspection, concrete is sprayed under pressure to coat the steel and form the walls and floor. Then it has to cure. This curing time is what makes gunite take months instead of weeks.

Some Tulsa yards are a better fit for a semi-inground pool than a fully inground build — especially yards with slope, limited access, or tighter budgets. See the difference between a semi-inground pool and an inground pool

Stage 6: Plumbing and Electrical

This is the most important stage most homeowners never see.

All the water lines, electrical wiring, and connections are installed here. This stage also determines how much your pool costs to run every single month.

Here's the difference between a pool that costs $12 a month to run and one that costs $150 to $200 a month.

Most builders use fittings that make sharp right-angle turns in the pipes. Water has to push hard to get through those turns. More resistance means more work for the pump. More work means more electricity used.

We use curved fittings that let water flow smoothly, like a highway on-ramp instead of a stop sign. Less resistance means the pump can run slower. A pump running slowly costs almost nothing to operate.,

Skimmer placement also gets decided here. In Oklahoma, wind blows from southeast to northwest about 80% of the time. We put the skimmer on the northwest side. The wind pushes debris toward it. You spend less time cleaning. It costs nothing extra to do this right.

Stage 7: Plumbing Pressure Test

Before the ground gets filled back in, every pipe gets tested for leaks.

Here's how it works. Air gets pumped into all the pipes. A gauge records the pressure. It sits overnight. If the pressure is still there in the morning, the pipes are solid, and backfill can start. If it dropped, there's a leak — and we find it and fix it before the yard closes up.

This step is not optional. It is the difference between catching a problem now and having to dig up your yard in 18 months.

Ask every builder you talk to whether they do this before backfill. If the answer is no, or "we check it at startup," you're being told something important.

Good to know: A small pressure drop of 1 to 2 PSI overnight is normal. Cold air contracts. A drop of 5 or more PSI means something needs attention.

Stage 8: Equipment Setup

The pump, filter, and controls get installed and turned on for the first time.

On filtration: most pools use one of three filter types. Sand filters are the most common and simplest. Cartridge filters give cleaner water and don't need backwashing. D.E. (Diatomaceous Earth) filters provide the clearest water but require more maintenance. For most Tulsa homeowners, a cartridge filter is the right balance of clean water and easy maintenance.

The pump also gets programmed here. This is the step most builders skip.

A pool pump can run fast or slow. Running it slow costs almost nothing. The goal is to cycle all the water through the filter two to four times a day. If the pipes are built right, the pump can do that at a low speed. We program every pump to match the exact size of the pool and the local electric rate schedule.

Most PSO customers pay more for electricity during peak hours, usually from 4:30 to 8:30 PM. We set the pump to run at its slowest during those hours. It costs almost nothing to run during that window. You get the savings automatically, every day, without thinking about it.

Stage 9: Concrete Coping and Decking

The deck is half the backyard. It's what you look at every day. It's also where you see the biggest difference between builders.

Decking materials compared:

MaterialCost Per Sq FtBest ForOklahoma Notes
Brushed concrete$6 – $10Durability, budget buildsHolds up well, needs sealing
Stamped concrete$12 – $18Custom look and textureBest value for visual impact
Pavers$15 – $25Premium look, easy to repairCan shift in Tulsa clay over time
Travertine$20 – $30Luxury finish, stays cool underfootPremium cost, less common locally
Exposed aggregate$10 – $16Slip resistanceGood in Oklahoma freeze-thaw conditions

Stamped concrete is the most popular choice at Silverado Rock. It looks like stone or slate at concrete prices. It also holds up through Oklahoma winters when properly sealed.

The edge of the deck that hangs over the pool water is called the cantilevered edge. It's the hardest part of pool concrete work. Not every contractor knows how to do it. Done wrong, it looks uneven and can crack away from the pool in a few years. Our concrete crew has been doing this for over 15 years.

One more detail worth knowing: most builders drop a white plastic lid over each skimmer opening in the deck. We pour custom concrete lids that match the deck surface. They look like part of the deck because they are. It costs about $200 extra per lid. You'll notice it every time you look at your backyard.

The deck gets sealed when it's done. We use commercial-grade Sherwin-Williams sealer. Not the kind from the hardware store.

Stage 10: Final Walkthrough

The last thing we do before we leave is walk you through your pool.

We cover how to test and balance the water. How to read the equipment. How to set the pump for the season. What to do before an Oklahoma freeze. What to do when you open it back up in spring. What's normal and what's worth a call.

A homeowner who knows their pool spends less money on it. One who got a manual and was left alone will pay a service company for problems they could have fixed themselves.

What Most Homeowners Get Wrong About the Timeline

Most people assume the builder controls how long the project takes. They don't control all of it.

Three things affect the timeline that no builder can change:

Permit offices. Once the application is filed, the city decides when it gets approved. No amount of follow-up speeds up a Bixby, Jenks, or Broken Arrow review.

Oklahoma weather. A wet spring delays digging. A cold snap delays concrete. Any builder who gives you a firm finish date in April without a weather caveat is either new to this or not being honest.

Equipment availability. Fiberglass shells are made to order. Sometimes they take longer to arrive. Pumps and automation systems have also had supply delays.

What you can control: start early. The people swimming by Memorial Day started planning in January. Find out the best time to start your Tulsa pool build — and use the timeline table at the top of this article as your planning benchmark.

What to Ask Every Tulsa Pool Builder Before You Sign

These eight questions will tell you everything you need to know about a builder.

  1. What does your site evaluation cover — and how does it change the price?
  2. Do you use curved fittings in the plumbing, or sharp 90-degree ones?
  3. What pump are you installing, and how will you program it?
  4. Do you test the pipes for leaks before you fill the ground back in?
  5. Who does your concrete work, and how long have they been doing pool decks?
  6. Which cities do you pull permits in regularly?
  7. Do you do a 3D design before filing permits?
  8. What happens if you hit unexpected soil during excavation?

A builder who answers every one of those questions clearly has done this many times. A builder who says "we take care of all that" without specifics is not being up front.

Frequently Asked Questions

How long does pool construction take in Tulsa?
It depends on the pool type. Fiberglass takes 3 to 5 weeks from permit approval to a finished pool. Vinyl liner takes 2 to 4 weeks. Gunite takes 3 to 6 months due to the concrete cure time. Add 1 to 3 weeks for permits before construction starts — Tulsa processes permits quickly; Bixby takes the longest, at 2 to 3 weeks.

What are the steps involved in building a pool?
There are 10 stages: site evaluation, 3D design, permit filing, excavation, pool shell or panel installation, plumbing and electrical, pressure testing, equipment installation and programming, concrete coping and decking, and pool school. Every Silverado Rock build follows this sequence in full.

What can delay a pool build in Tulsa?
The three most common causes are permit timelines, Oklahoma weather, and equipment availability. Permit offices don't accelerate for anyone once an application is filed. Spring rain saturates clay soil, stopping excavation. Fiberglass shells are made to order and can take extra weeks to arrive. Starting the process in fall or winter is the most reliable way to be swimming by summer.

Do I need a permit to build a pool in Tulsa?
Yes. Every inground pool in the Tulsa area requires a permit. Requirements vary by city — Tulsa, Broken Arrow, Bixby, Jenks, and Owasso all have their own applications, documentation requirements, and timelines. Silverado Rock handles permit filing for every project we build. Homeowners who file their own permits frequently cause delays by missing required measurements or documentation.

What pool type is fastest to build in Tulsa?
A vinyl-liner pool is the fastest to install, at 2 to 4 weeks from permit approval to finished pool. Fiberglass pools are close behind at 4 to 6 weeks. The fiberglass shell arrives pre-manufactured, so there is no waiting for concrete to cure on-site. Gunite takes significantly longer — 3 to 6 months — because the shell is built and cured on-site.

How do I prepare my yard for pool construction?
Call 811 to have utility lines marked at least three business days before excavation. Remove fence sections that block equipment access. Clear furniture and plants within 15 feet of the pool footprint. Confirm HOA approval is in hand before construction starts. If you are not on city sewer, locate your septic system. A good builder will walk through this checklist with you before the crew arrives.

How much does it cost to build a pool in Tulsa?
Most completed inground pool installations in the Tulsa area range from $35,000 to $150,000, depending on pool type, size, features, and site conditions. Fiberglass and vinyl liner builds typically start around $45,000 to $50,000. Gunite builds start at a higher price due to longer construction timelines and greater customization. See the full cost breakdown for Tulsa inground pools.

Ready to Start?

The process is only scary when you don't know what's coming. Now you do.

Silverado Rock starts with a real site evaluation. We design your pool in 3D before any permits are filed. We handle every permit in every city where we build. We test every pipe before the ground closes up. We set up your equipment to run so that you save money. And we walk you through everything before we leave.

Call Jason directly at (918) 230-4997 or schedule your free site evaluation.

No call center. No sales team. Jason reads every request himself and gets back to you within one business day.
